Friday, October 28, 2011

● Meeting Hall Construction Update as of October 28, 2011

1. Praise the Lord! The tilt-up wall panels were lifted and placed in position within 3 days, from October
    26 to 28.
2. With the completion of this important aspect, the next step to be done this week is the installing of the
    structural steel frame.
3. After the panels have been welded to the foundation slab, to one another, and to the structural frame, the
    temporary braces will be taken down. Work on the roof will be next, followed by the pouring of
    concrete for the slab of the second floor.
4. We are one month ahead of schedule. Payments will also become due sooner. May the Lord fulfill His
    work in us to supply what we need. We thank and praise Him for His faithfulness.


Offering for the meeting hall construction, as of October 23, 2011
Offering Goal
Current Accumulated Offerings
Current Disbursement
Current Balance
$4,500,000 (CAD)
$2,840,762 (CAD)
Project Fund
Security Deposit
Total Expenditure
$617,397 (CAD)
$1,635,365
$588,000
$2,223,365 (CAD)

Percentage of our Goal Achieved at present
Current Deficit
63.13%
$1,659,238 (CAD)



Attached (above picture) is the latest view of the meeting hall.

All the wall panels (double-reinforced concrete panels formed on site horizontally) were tilted up within three days, October 26 to 28.
The picture was taken from the opposite side of Brown Road.

Starting the first week of November, the structural steel frame will be constructed over the wall panels at the top, after which the roof will be installed.

We hope the brothers who will be attending the Canada Brothers Conference can come to the construction site after lunch on Saturday, November 5.
The general contractor's top brass will be available on site to give us a guided tour of the building-in-progress. I just have to confirm the time with them
after the brothers decide on when to visit the site.


All the wall panels have been placed in position. This video shows the west sector of the building, which will be separated into two floors. The second floor will be built later after the structural steel frame is installed. Rectangular notches along the west wall are the points where floor joists will be connected to the wall. Braces temporarily hold the panels in place until they are welded to the floor slab and the roof frames.



Wednesday, October 26, 2011, amidst the rain, workers began as early as 7:00 a.m. to lift the wall panels up. In a designated order,  6 panels were put in place by 9:30 a.m.


The sky had cleared by late afternoon of Wednesday, Oct. 26. The crane had been moved inside to raise and install the panels on the entire east wall and most of the south wall. Photo was taken from across the street.


Tuesday, October 25, 2011

● Meeting Hall Construction Update as of October 23, 2011

  1. Under a sunny sky on October 19, the pouring of concrete on the second set of wall panels proceeded smoothly.
  2. On Thursday and Friday, the steel braces for lifting the wall panels were laid in place, ready for the panels to be erected by a crane.
  3. The wall panels will be installed on Tuesday or Wednesday this week. Saints who wish to witness this operation may come to the site to observe. You man park your cars at a safe distance from the site, near the corner of Cambie Road, or at the parking lot of the school on Odlin Crescent.
  4. From this point on, the construction will proceed faster and so will the payments for the works accomplished. May the Lord increase our capacity and cause His blessings to abound to the church in all our practical needs.


Offering Goal
Current Accumulated Offerings
Current Disbursement
Current Balance
$4,500,000 (CAD)
$2,830,887 (CAD)
Project Fund
Security Deposit
Total Expenditure
$652,425 (CAD)
$1,590,462
$588,000
$2,178,462 (CAD)
Percentage of our Goal Achieved at present
Current Deficit
62.90%
$1,669,113 (CAD)

Wednesday, October 19, 2011

● Meeting Hall Construction Update as of October 18, 2011

A concrete working for the last wall panel

Video shows concrete being poured on the last wall panel at 11:30 a.m. on October 18, 2011.


Three pictures show concrete works on Oct. 16,2011





● Meeting Hall Construction Update as of October 14, 2011

1. The concreting of most of the sidewalk was done on October 13. The remaining offsite works are the landscaping, installing of street
lamps, relocating the electric poles to be done by BC Hydro, realigning the gas main to be done by FortisBC, and the final asphalt paving
(to be done next year at the end of construction).
2.  The City Parks department personnel inspected the site on October 14 to decide on the cutting of trees standing on city property.
3.  The second set of more than 20 wall panels are in preparation and pouring of concrete will be done this week. The work progress is two
to three weeks ahead of schedule because of good weather. The wall panels will be erected after curing in a few days. By the fourth week
of October, structural steel will begin to be installed for the second floor and the roof frame.
4.  Last week, we paid out $248,000 to the general contractor and $132,000 to the offsite works contractor.
5.  Praise the Lord for His faithfulness in providing us with the right weather for the work to proceed uninterruptedly and sufficient supply to pay the progress billings as they become due each time.


The church construction committee met with the architect and the general contractor's key personnel on October 12, 2011 to discuss the latest work progress and construction schedule update. Photo shows the project team standing on the first set of concrete wall panels, over which a second set of about 20 panels will be cast in a week's time.

                                          Offering for the meeting hall construction, as of October 09, 2011



Offering Goal
Current Accumulated Offerings
Current Disbursement
Current Balance
$4,500,000 (CAD)
$2,807,564 (CAD)
$2,178,462 (CAD)
$629,102 (CAD)
Percentage of our Goal Achieved at present
Current Deficit
62.39%
$1,692,436 (CAD)

Monday, October 10, 2011

● Meeting Hall Construction Update as of October 10, 2011

Development of the Sidewalk and Grass Area






Photo shows the pedestrian sidewalk and grass area being laid out. A layer of sand is tamped in place before the pouring of concrete.

Concrete Delivery and Wall Panels

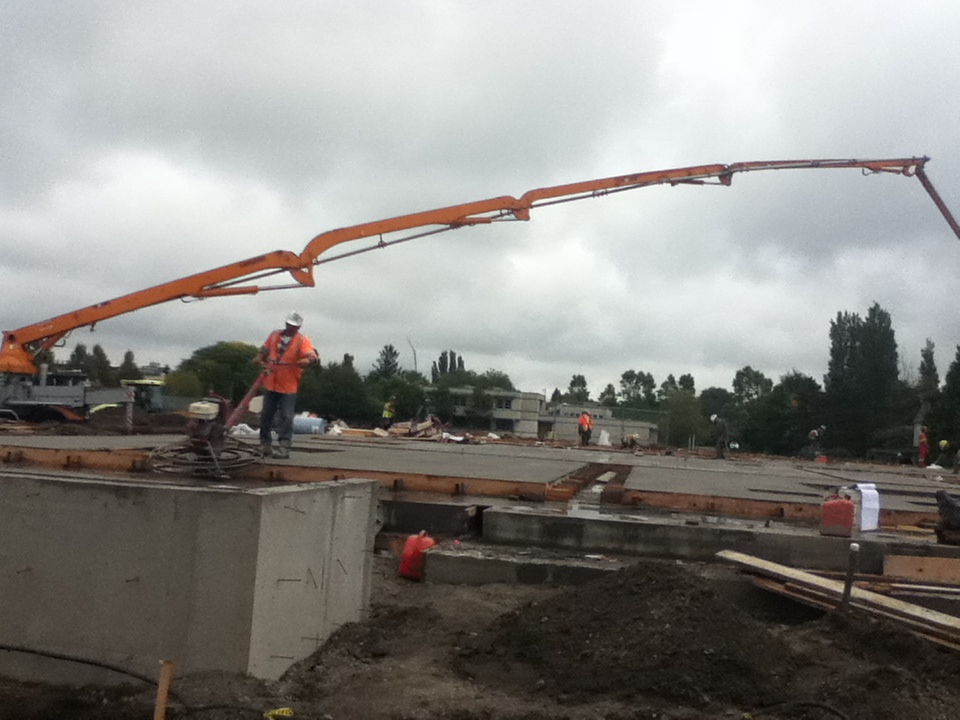

A concrete mixer truck backs into the driveway to deliver another batch of concrete to be pumped into the forms for the wall panels.


Worker in the foreground uses a hand operated power trowel to polish the surface of an earlier poured wall panel while other workers in the background continue to guide the hose to pour concrete into the unfinished panels.


Wall panels in the making, video taken on October 7, 2011.

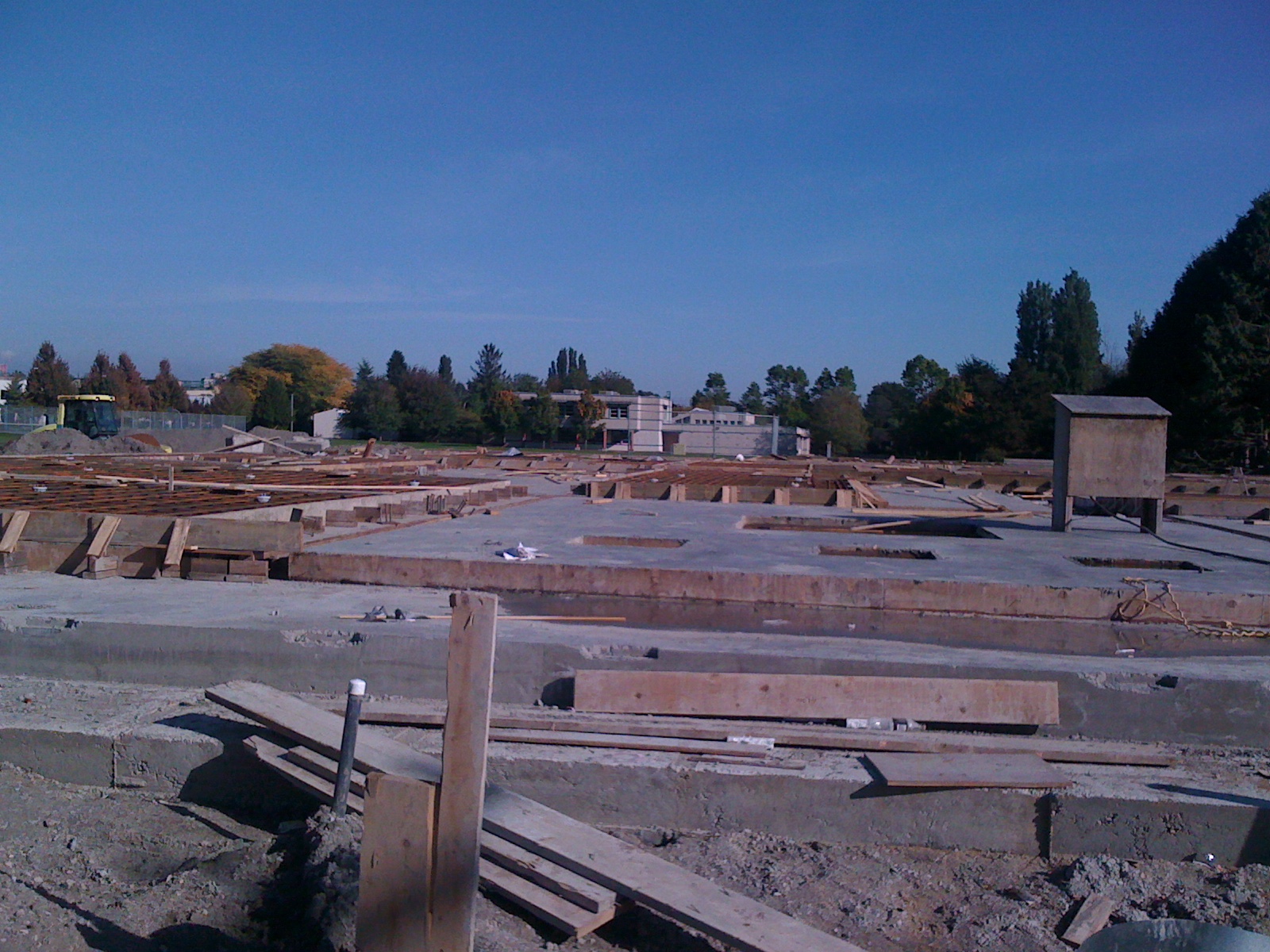

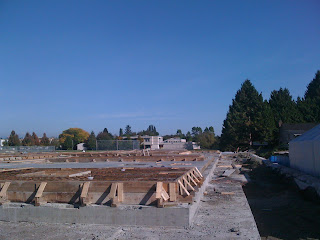

The finished wall panels, lying under a clear sky, will cure over the Thanksgiving long weekend, and will be ready for another set of panels to be formed on top of them. After all the wall panels have set and attained proper strength, they will be tilted up and installed upright on the foundations.

Status Update
  1. As of October 7, the first set of concrete wall panels has been cast. The good weather on Friday helps with the curing process over the Thanksgiving long weekend.
  2. The next sets of panels will be done during the following 3 weeks. By the end of October, the wall panels will be ready for lifting upright to complete the walls of the building.
  3. A site meeting is scheduled on Wednesday, October 12, with the architect and contractors to review the accomplished work and current progress of the construction. This week, sizable amounts have to be paid to the general contractor and to the road-works contractor.
  4. The letter of credit held by the City of Richmond will be reduced by an amount corresponding to the sewer and road works accomplished and approved.
  5. Praise the Lord for His sufficient supply. May we continue to pray for the timely offerings to meet the needs of the construction.
Current Status on Material Offerings

Offering GoalCurrent Accumulated OfferingsCurrent DisbursementCurrent Balance
$4,500,000 (CAD)$2,740,088 (CAD)$1,795,960 (CAD)$944,128 (CAD)
Percentage of our Goal Achieved at PresentCurrent Deficit
60.89%$1,759,912 (CAD)

Wednesday, October 5, 2011

● Meeting Hall Construction Update as of October 4, 2011

This is the future wall panel on the northwest corner of the main sanctuary.

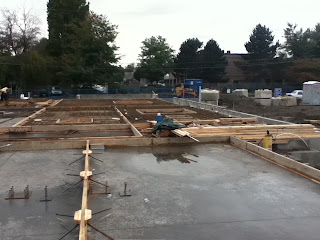

The boxed areas are the openings for the glass windows. After rebars are placed in the spaces between the forms, concrete is scheduled to be poured on October 7.




The longer wood frames are the outer edges of the wall panels. The boxed areas inside are window openings. Reinforcing steel bars will be installed between the wooden forms and concrete will be poured into the spaces. After the concrete cures, the panels will be tilted up to form the walls of the building.


Photo shows workers laying rebars inside the forms in preparation for concrete pouring for the wall panels.


Status on September 30:

  1. The first layer of asphalt paving was done on September 27. The road works are 85% complete and a payment of $128,000 is due this week.
  2. Reinforcing bars were laid on Sept. 27, and pouring of the concrete floor slab and polishing of the slab were done on Sept. 28.
  3. Work on the wall panels began on Sept. 29 with laying out measurements and building the forms for each individual panel.
  4. The sidewalk construction began on Sept. 30. Foundation work and wiring for street lighting are 50% completed.

Current Status on Material Offerings:
Offering GoalCurrent Accumulated OfferingsCurrent DisbursementCurrent Balance
$4,500,000 (CAD)$2,715,669 (CAD)$1,795,960 (CAD)$919,709 (CAD)
Percentage of our Goal Achieved at PresentCurrent Deficit
60.35%$1,784,331 (CAD)



Saturday, October 1, 2011

● Sidewalk & Concrete Floor Slab Videos


Video shows work being done on the sidewalk on our side of Brown Road and on the road shoulder of the opposite side.


Video showing the concrete floor slab pouring on Construction Site
